A failed cutover at 2 a.m. is not a theoretical risk. It happens when teams move terabytes of customer records without a tested rollback plan, discover broken foreign key relationships after go-live, and spend the next week manually reconciling data while operations grind to a halt. Following cloud data migration best practices is not a nice-to-have — it is the difference between a controlled transition and a production incident that lands in your incident report.
Most migrations fail for predictable reasons: skipped dependency mapping, no data quality checks before transfer, and security controls configured after the data is already live. None of those are surprises. All of them are preventable.
This post covers exactly how to prevent them. You will get a concrete walkthrough of pre-migration planning, dependency mapping, strategy selection, AWS tooling choices, validation methods, security controls, rollback preparation, and a copy-paste checklist you can drop directly into your project plan.
A solid cloud data migration checklist is the difference between a migration that runs on schedule and one that unravels mid-transfer. Before you dig into the detailed steps in this guide, use this phase-by-phase framework to keep your team aligned from day one through final cutover.
Each phase below maps directly to a deeper section further in this post. Treat every item as a hard gate, not a suggestion.
Phase 1: Plan
Phase 2: Inventory
Phase 3: Prepare
Phase 4: Migrate
Phase 5: Validate
Phase 6: Optimize
Want a pre-built version of this checklist you can drop straight into your project tracker? Download our cloud data migration planning worksheet to get a ready-to-use template with owner fields and phase sign-off columns already built in.
Before you build a runbook or pick a tool, define what success actually means. Most teams skip this and spend the back half of their migration arguing about whether it's "done." That argument is expensive.
The migrations that finish on time and without scrambling share three consistent traits regardless of company size or stack.
Clear scope before anything moves. You know exactly which data is migrating, where it's landing, and what's deliberately staying behind. Ambiguity here doesn't surface until cutover week, and by then it costs real time.
Tested rollback procedures. Not documented. Tested. There's a significant difference between having a rollback plan written down and having your team rehearse it against a real failure scenario. Build the exit before you start the move.
Validation as a core phase, not a cleanup task. Row counts, checksums, referential integrity checks, all of it runs after every batch transfer. Not once at the end.
Here's a concrete example of what happens when these traits are missing. A mid-market SaaS company migrated roughly 600 GB of customer records to AWS RDS. The team skipped a pilot run and went straight to full cutover. Foreign key relationships broke across three tables during the transfer. The discovery came 36 hours post-cutover.
The remediation took nine days. That included 140+ hours of engineering time manually reconciling records, a rollback of two downstream services, and a four-day freeze on the release calendar. Total estimated cost: just over $80,000 in engineering labor and opportunity loss.
A pilot migration on 10 percent of that data set would have surfaced the same foreign key issue in a controlled environment. Fixing it at the pilot stage typically takes four to eight hours. The math is not subtle.
Catching a schema issue during a pilot costs hours. Catching the same issue after full cutover costs weeks.
Compare that to teams that run a proper pilot: the average fix-it-early cost runs between $2,000 and $5,000 in engineering time. Post-cutover recovery for the same class of error routinely lands between $40,000 and $120,000 once you factor in downtime, incident management, and delayed business operations.
Most migration failures trace back to the same handful of decisions.
None of these are exotic edge cases. They appear consistently across migrations of every scale.
Your migration is complete when you can confidently decommission the source environment. Not when data finishes moving. Not when your monitoring tools go green. When you can shut off the source and nothing breaks.
That standard requires four things to be true simultaneously.
Data integrity confirmed. Row counts and checksums match between source and target for every migrated data set. Referential integrity checks pass in the target environment with no manual overrides.
Application behavior verified. Every application that reads from or writes to the migrated data runs against the target environment in a staging configuration first. All critical workflows produce identical results to what they produced on the source.
User acceptance signed off. The teams who actually use these systems have tested their core workflows and confirmed acceptable behavior. This isn't a formality. It catches display and logic issues that technical validation misses.
Source decommission readiness confirmed. No active process, scheduled job, or application is still reading from the old system. Every dependency that pointed at the source now points at the target, verified, not assumed.
When all four conditions are true, the migration is done. Until then, it's in progress regardless of what the transfer logs say.
Before a single record moves, you need three things locked in writing: what you're trying to achieve, what's explicitly in scope, and how you'll know the migration succeeded. Teams that skip this step end up chasing shifting requirements mid-transfer while stakeholders pile on new asks. Define your business outcome first. Not "move to the cloud" but something like "cut infrastructure spend by 25% within 90 days of cutover" or "eliminate our data center lease by Q3." That specificity drives every decision downstream.
Scope boundaries matter just as much. List every data source moving, then explicitly document what stays put. A written out-of-scope list prevents the slow scope creep that quietly extends timelines by weeks.
Each objective needs a metric with a baseline captured before migration starts. Measuring after the fact gives you nothing to compare against. Use the table below to structure your tracking across the full migration lifecycle:
| Metric Name | Baseline Value | Owner | Target Threshold | Measurement Cadence |
|---|---|---|---|---|
| Monthly infrastructure cost | Current invoiced amount | Finance lead | 25% reduction at 90 days post-cutover | Before, at 30 days post-cutover, at 90 days post-cutover |
| Record count match | Source row totals per table | Data engineer | 100% match | After each batch transfer |
| Cutover downtime | Last 3 maintenance windows average | Platform lead | Under 2 hours | During cutover window only |
| Query response time | P95 latency on source | Backend lead | Equal to or better than baseline | Before, during parallel run, after cutover |
| Compliance audit status | Last audit date and findings | Security lead | Clean audit within 30 days | Before migration and at 30 days post-cutover |
For a ready-to-use version of this structure, refer to our KPI tracking template to adapt it directly to your project scope.
Metrics only tell part of the story. Your planning assumptions need to account for the operational constraints that will actually determine whether you hit your timeline.
Data volume drives everything else. A 500 GB database migrates very differently from a 15 TB data warehouse. Calculate your total transfer size after deduplication and archival cleanup, not before.
Bandwidth is the next constraint. If you're transferring over the public internet, factor in realistic sustained throughput rather than theoretical maximums. A 1 Gbps connection rarely sustains full capacity during business hours. For anything over a few terabytes, AWS Snowball or Direct Connect usually beats network transfer on both speed and cost predictability.
Transfer window sizing requires honest conversation with your operations team. Batch transfers during off-peak hours reduce application risk but extend your overall timeline. Build that tradeoff explicitly into your schedule rather than discovering it when you're already behind.
Timeline estimates should include buffer for the phases that always run long: dependency mapping, data cleaning, and validation. A rule of thumb that holds up in practice is to add 30% to your initial estimate for anything under 5 TB, and 50% for larger or more complex environments.
Cost assumptions need to cover data egress fees, tool licensing, engineer time, and parallel-run costs while both environments stay live. Teams consistently underestimate the parallel-run period. If your source and target overlap for three weeks, you're paying for both.
A migration rollback plan is not a document you write to satisfy a checklist. It is the decision framework your team needs when something breaks at 2 AM during cutover.
Trigger conditions. Define the specific signals that initiate rollback before you start the transfer. Examples: row count discrepancy exceeding 0.5%, application error rate spiking above 5% post-cutover, or critical foreign key validation failing on more than 10 tables. Vague triggers like "if things go badly" produce paralysis when pressure is highest.
RTO and RPO targets. Your Recovery Time Objective sets the maximum tolerable downtime before rollback must complete. Your Recovery Point Objective defines the maximum data loss your business can accept. Both numbers need sign-off from a business stakeholder, not just engineering. A fintech client might set RTO at 30 minutes and RPO at zero. A lower-priority internal tool might tolerate four hours and a few minutes of data loss.
Decision owners. One person calls the rollback. Name that person before migration day. Decisions by committee under pressure produce delays, and delays compound the damage. Document a backup decision owner in case the primary is unavailable.
Communication steps. Rollback triggers a notification sequence, not a private engineering fix. Stakeholders, support teams, and affected business units need immediate notification with a plain-language status update. Draft the rollback communication template in advance so no one is writing it from scratch at 3 AM.
Rehearsal requirements. Your rollback procedure only counts if your team has run through it end-to-end at least once before the production cutover. Treat the pilot migration as your rehearsal opportunity. Time the rollback, document what worked, and fix what didn't. An untested rollback plan is not a plan.
For the full technical runbook covering rollback sequencing, data restoration steps, and environment reconfiguration, see our migration rollback runbook.
Discovery work only pays off when it produces something you can actually execute against. Raw notes and tribal knowledge are not a plan. You need a structured inventory where every dataset has a complete record before a single byte moves.
For each data source, capture these fields without exception:
Missing even one of these fields creates a decision gap later. Compliance class alone determines your encryption and access requirements. SLA determines whether you can afford a maintenance window or need live replication.
This is where most inventory work falls apart. Listing datasets is straightforward. Understanding every process that touches them is not.
A complete dependency mapping exercise captures more than just application connections. For each dataset, document the upstream producers writing data into it, the downstream consumers reading from it, any APIs that depend on it, scheduled batch jobs that run against it, reports or dashboards that query it, credentials and service accounts used for access, the refresh cadence, and the restart sequence after a failure or cutover.
That last field matters more than teams expect. If your order management application must come online before the notification service, but you bring up the notification service first, you get errors at best and corrupted event queues at worst.
For a database-backed application, a realistic migration order looks like this:
Each step gates the next. Skipping ahead because one step looks complete is how cutover failures happen at 2am.
Once your inventory is complete, classify every dataset across two dimensions: sensitivity and business value. Sensitivity tells you how much protection the data requires. Business value tells you whether migrating it is worth the cost and effort at all.
Data that is obsolete, duplicated, or never accessed by any active process does not belong in your new cloud environment. Archive what has compliance retention requirements, delete what does not, and deduplicate anything with redundant records before the transfer begins.
Running deduplication and deletion against your source environment rather than your target environment keeps your migration scope tight. A 20 percent reduction in total data volume cuts transfer time, lowers first-month storage costs, and gives your validation checks a smaller surface area to cover. That is not a minor optimization. On a multi-terabyte migration, it is the difference between a 6-hour window and a 10-hour one.
Treat scope reduction as an engineering decision, not a cleanup task you squeeze in at the end.

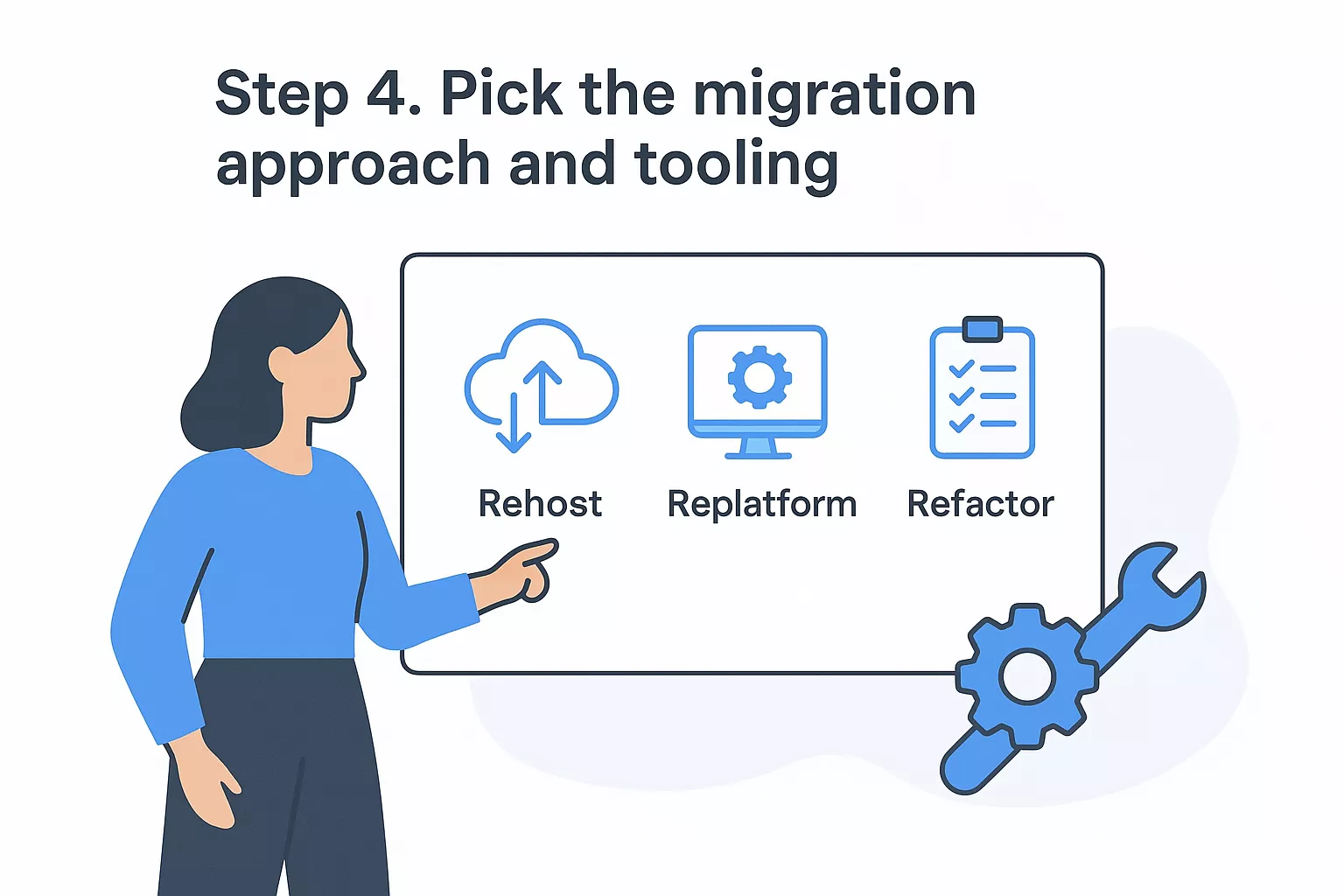

Your cloud migration strategy should follow your workload, not your comfort zone. The single most expensive planning mistake is defaulting to one approach across every data set because it feels simpler. A transactional database running live customer orders has completely different constraints from a five-year-old analytics warehouse or a file repository full of archived documents. Treat each workload on its own terms.
Here's a practical decision framework across the five core strategies:
Rehost moves data as-is onto cloud infrastructure. It's fast, low-risk from a code perspective, and works well for file repositories or stable databases where you're not trying to modernize. The tradeoff: you carry your current inefficiencies into the new environment.
Replatform introduces targeted changes, typically swapping a database engine or shifting to a managed service like Amazon RDS. For transactional databases, this often means near-zero code changes with meaningfully lower operational overhead on the other side. Downtime is moderate and manageable with proper staging.
Refactor is the heavy lift. You redesign the data architecture to take advantage of cloud-native services. For analytics stores, refactoring to something like Amazon Redshift or Aurora can cut query times dramatically, but expect real engineering effort and higher short-term cost. Not the right call for a tight deadline.
Retain makes sense when active compliance dependencies or hard application coupling make migration genuinely risky right now. Don't migrate just because you can.
Retire is often the most underused option. If a data set has no active consumers, decommission it before migration begins. It reduces transfer volume, cuts storage cost, and removes compliance surface area you never needed.
The tradeoffs by workload type break down clearly. Transactional databases (PostgreSQL, MySQL, Oracle) demand low downtime tolerance, minimal code change, and careful handling of referential integrity during transfer. Analytics stores can usually tolerate longer cutover windows in exchange for a more optimized target schema. File repositories are the most straightforward candidates for rehost, with high volume but low structural complexity.
Once you've assigned a strategy per workload, match it to the right tool.
| Tool | Use It When | Avoid It When | Supported Data | Migration Mode | Downtime Fit |
|---|---|---|---|---|---|
| AWS Database Migration Service | Moving structured relational data between engines with minimal downtime | Migrating unstructured files or large binary objects | Relational DBs, data warehouses | Continuous replication or one-time | Low to zero downtime |
| AWS DataSync | Transferring files, objects, or NFS/SMB shares at scale | Migrating live transactional databases | Files, S3 objects, NFS, SMB | Scheduled or on-demand | Tolerates planned downtime |
| AWS Snow Family | Moving massive data volumes where network transfer would take weeks | Small data sets under a few terabytes | Any data type, physical transfer | Offline physical shipment | High downtime tolerance required |
| AWS Migration Hub | Tracking progress across multiple tools and workloads | Executing the actual data transfer itself | Metadata and tracking only | Orchestration layer only | N/A, monitoring only |
AWS Database Migration Service deserves special attention for transactional workloads. It supports continuous data replication, which lets you keep your source database live while the target catches up, then cut over during a minimal window. That capability directly addresses the downtime constraint that makes DBAs nervous about migrating production databases. For a deeper look at how DMS handles schema conversion, replication slots, and heterogeneous migrations, the Brilworks AWS DMS guide covers the specifics you'd want before committing to a configuration.
Pick your strategy per workload. Match your tool to the strategy. Then lock both decisions before you build your runbook.
Access control is not something you configure after data lands in the target environment. Set it up before a single record transfers, test it against real roles, and get explicit sign-off before cutover begins. The table below defines the structure your team needs in place.
| Role | Permissions | Owner | Approval Required | Sign-off Before Cutover |
|---|---|---|---|---|
| Migration Engineer | Read/write on target data stores | Backend Lead | Migration Manager | Yes |
| Security Reviewer | Read-only audit access | Security Lead | CISO | Yes |
| Data Validator | Read-only on source and target | QA Lead | Migration Manager | Yes |
| Business Approver | None (sign-off only) | Product Owner | N/A | Yes |
Every role operates on least-privilege access from day one. Grant the minimum permissions needed for each function, deny everything else by default, and document each decision in your governance log. No exceptions for convenience.
Start with 5 to 10 percent of your total data volume as a controlled pilot. Pick a representative subset, not your smallest or simplest data set. A pilot that's too easy tells you nothing useful.
Run the full sequence: transfer, validate, and test application behavior against the migrated data. Document transfer speed, error count, and any manual fixes your team had to make. Use those numbers to refine your runbook and timeline before you scale.
A pilot that surfaces a configuration problem is exactly what it's supposed to do. Finding that same problem mid-full-transfer is far more expensive to fix.
Validation is not a box to tick after the data moves. Run checks after every batch, not just at the end of the full transfer. Catching a discrepancy in batch three means a contained fix. Catching it after batch thirty means tracing an issue through your entire transfer history.
For databases, run these checks on every batch before signing off:
For files, the checks shift slightly. Compare manifests from source and target to confirm every file transferred. Verify hash totals file by file for regulated content. Flag any size discrepancy greater than zero bytes for investigation before batch sign-off.
Acceptable variance thresholds should be defined before migration starts, not negotiated in the moment. For regulated data, the threshold is zero. For non-regulated archival data, your team can agree on a small percentage in advance, document it, and require a named approver to sign off on any batch that falls within that range.
Cutover testing is the final gate before you declare the migration complete. Point your applications at the target environment in a staging configuration and run through this validation sequence.
Start with smoke tests: confirm every major user-facing workflow loads without errors. Follow with targeted read checks on your highest-volume queries, then write checks that create, update, and delete records to confirm the target data store handles transactions correctly. Run your standard performance benchmarks against both environments and compare. If response times on the target are more than 10 to 15 percent slower than your source baseline, that needs a root cause before you go live.
Go criteria: all smoke tests pass, read and write checks return correct results, performance benchmarks meet or beat baseline, and every named approver from your RBAC table has signed off in writing.
No-go criteria: any checksum mismatch still open, any smoke test failure, any foreign key constraint error unresolved, or any approver sign-off missing.
Only after your go criteria are met do you schedule source environment decommission. If any application or pipeline still reads from the source, the migration is not finished. Hold that line, and your team stays honest about what "complete" actually requires.
Reading a migration guide is one thing. Actually starting the work on Monday morning is another. Here is a concrete five-day plan that turns the steps above into daily execution, with a named owner and a deliverable at the end of each day. By Friday, you will have everything you need to run a confident pilot migration the following week.
Day 1: Data Inventory
Owner: Data or infrastructure lead
Pull every data source your team touches into a single shared document. Databases, flat files, data warehouses, APIs that write or read data. For each source, record the type, approximate size, and the team responsible for it. Do not worry about cleaning or classifying yet. The goal today is a complete list with no gaps.
End-of-day artifact: A raw data inventory spreadsheet, shared with all relevant teams and version-controlled.
Day 2: Dependency Mapping
Owner: Backend or platform engineer
Take yesterday's inventory and trace the connections. For each data source, pull connection logs and identify every application, service, or scheduled job that reads from or writes to it. Flag any dependencies that cross team boundaries.
End-of-day artifact: A dependency matrix showing each data source, its upstream and downstream connections, criticality rating, and the required startup sequence post-cutover.
Day 3: Classification and Cleanup Planning
Owner: Data lead plus compliance or security owner
Assign a sensitivity label (public, internal, confidential, regulated) and a business value tier (active, archival, obsolete) to every item in the inventory. Flag data sets that need cleanup before transfer: duplicates, null required fields, broken foreign keys.
End-of-day artifact: An annotated inventory with classification labels, a cleanup task list assigned to specific owners, and a list of obsolete data sets flagged for deletion or archiving.
Day 4: Strategy and Tooling Decision
Owner: Tech lead or architect
For each data source, assign a migration strategy from the five-option framework covered earlier in this post. Then match each source to a specific tool. Lock these decisions before day five.
End-of-day artifact: A completed strategy-and-tooling table, plus a draft rollback plan documenting what happens if the transfer fails at each stage. This rollback draft becomes the foundation of your full runbook.
Day 5: Pilot Scope and Validation Design
Owner: Migration lead
Select 5 to 10 percent of your total data volume as your pilot batch, ideally from a non-production or low-sensitivity source. Define exactly which integrity checks run after that pilot completes: row count comparison, checksum verification, referential integrity queries.
End-of-day artifact: A validation runbook with specific queries, expected outputs, and pass/fail criteria, plus a cutover checklist that your team will sign off against before any production data moves.
Five days of focused work produces the documentation foundation that most teams skip entirely. That is precisely why they hit problems at cutover that these artifacts would have caught on day two.

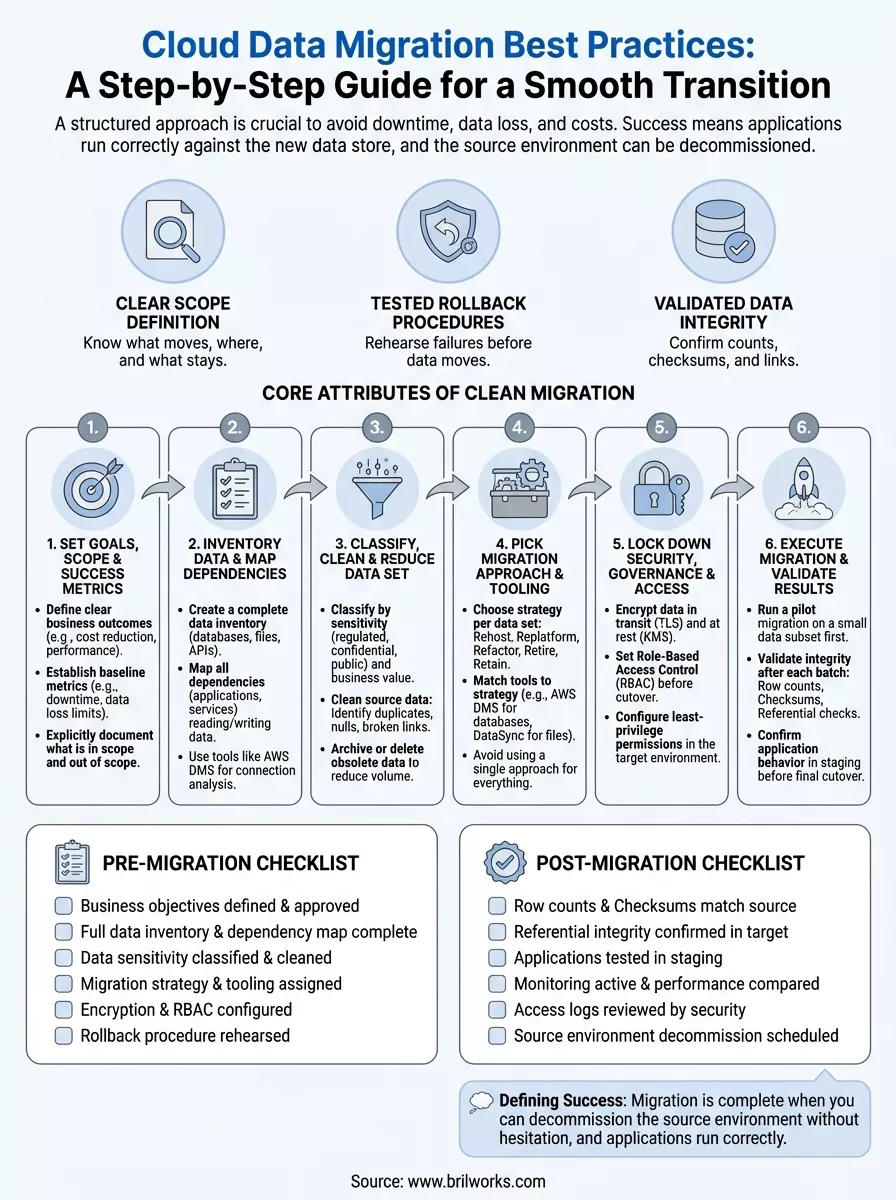

Cloud data migration best practices are fundamentally about risk reduction, not speed. Moving data quickly is easy. Moving it correctly, without breaking applications, exposing sensitive records, or inheriting the quality problems of your old environment, requires planning that most teams underestimate.
Three things deserve your attention before anything else. First, lock your inventory and dependency map before touching a single production data set. Discovering a missed dependency at cutover is the most avoidable crisis in migration work. Second, run a pilot migration and actually test your rollback procedure end-to-end. Third, treat validation as a gate, not a formality. Row counts, checksums, referential integrity checks: none of them are optional.
Go back to the pre-migration checklist and the first-week execution steps. Those give you the concrete sequence to follow.
If you want experienced engineers reviewing your architecture, assessing your current environment, or running cutover planning alongside your team, Brilworks is the right conversation to have. Reach out for a migration assessment and we will tell you exactly where your plan is solid and where it carries risk.
Cloud Data Migration Best Practices are proven strategies and methodologies for successfully moving data from on-premises systems or other clouds to cloud platforms while ensuring data integrity, security, minimal downtime, and compliance. These Cloud Data Migration Best Practices include comprehensive planning, data assessment, validation processes, security protocols, and risk mitigation strategies that prevent data loss and business disruption.
Following Cloud Data Migration Best Practices is critical because poor data migration can result in data loss, security breaches, extended downtime, compliance violations, cost overruns, and failed migrations. Organizations implementing Cloud Data Migration Best Practices experience 60-80% fewer migration issues, reduced downtime, better data quality, and faster time-to-value compared to ad-hoc approaches.
Essential steps in Cloud Data Migration Best Practices include data discovery and assessment, defining migration strategy and scope, selecting appropriate tools and methods, data cleansing and preparation, establishing security and compliance protocols, executing pilot migrations, performing full-scale migration, validating data integrity, optimizing performance, and implementing ongoing monitoring and governance.
Data assessment in Cloud Data Migration Best Practices involves inventorying all data sources, analyzing data volume and growth rates, identifying data dependencies and relationships, evaluating data quality and accuracy, determining compliance requirements, calculating storage and transfer costs, and identifying sensitive data requiring special handling. Thorough assessment is foundational to Cloud Data Migration Best Practices.
Security in Cloud Data Migration Best Practices requires encryption for data in transit and at rest, secure transfer protocols (TLS/SSL), access controls and authentication, data masking for sensitive information, compliance with regulations (GDPR, HIPAA), network security configurations, audit logging, and backup procedures. Cloud Data Migration Best Practices treat security as non-negotiable throughout the process.
